Skip to main content

Primavera P6 Tutorial : Chapter 4.4 : Updating and Scheduling Projects

One should update project schedule so as to maintain, record progress and keep on track.
Updating schedules can be either done by directly applying actuals or by using the timesheet updates from the project reporter module.
Once you are done with the updating of actual progress dates and % progress, you can schedule the project so as to see the impact of the delayed progress.
Remember to always update your schedule regularly so as to keep yourself updated. While updating, you will notice that the actual durations vary from the original durations, there may be additional modifications compared to baselines as well.
Scheduling Methodology:
  1. Firstly, identify the types of data to collect relating to activities and resources. Always collect actual dates and remaining durations/resources.
  2. Determine how the said data shall be collected. Standardize the method of collecting the data.
  3. Determine how often the data should be collected and updated
  4. Analyze and communicate the data: Once you update the schedule, analyze the results and communicate to the teams accordingly on the impacts
 Methods of Updating:
Schedules can be updated in various methods, you can use the combination of methods as well. When you only need to estimate progress, you can choose the “auto compute actuals”. This method can be applied only when the schedule is on track, all the activities are performed as per the schedule.
Before you choose the method for updating, the update process should be in the following order:
  1. Establish a Scheduling philosophy, which includes the method to choose, filters, percent types, duration types
  2. Create a Latest baseline, if not available
  3. Record progress on activities from the data that has been collected or record automatically
  4. Apply project actuals by entering the actual dates/resource units and remaining durations/resources left
  5. Schedule the project and also level the resources
  6. Once you are done, to analyze the results, compare the schedule with the baseline and identify variances to report the impact of scheduling
  7. Prepare reports in various formats for understanding and analyzing
  8. Publish and communicate the schedule update report to stakeholders
4.4.1 Updating Progress using Spotlight:
If activities are progressing on schedule and you may want to estimate progress for all activities by simply updating the activities that fall behind the new data date. By updating these activities, the impact shall be automatically shown when you schedule the project
This is the most convenient way to update the project .The Project Management module estimates progress only for those activities that were supposed to take place. Remember to review all incomplete activities to make sure that their remaining durations, actual dates, and percent complete values are realistic

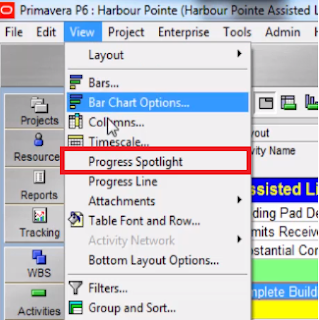

Spotlight feature: Choose View, Progress Spotlight, or click the Progress Spotlight icon to highlight the time period from the previous data date.


To increase/decrease the highlighted spotlight area, drag the data date line to the right or the left. Click the data-date line, it changes to an arrow, drag the line to the right until you reach the new data date. Then the PM module spotlights the activities between the last data date and the new data date.

To estimate the progress of the spotlighted activities:
Once you are done with the spotlighting of the activities falling during the desired time period, Choose Tools, Update Progress.

Select a new data date if the one shown is not correct. Select the options to choose to update all activities scheduled to work during the current update period or only selected activities. And then click Apply.

Then the P6 PM module estimates percent completion values and remaining durations for activities that are not finished as on data date and sets dates to actual dates if they fall before the new data date. Module also updates resource assignments based on each activity’s revised percent complete and remaining durations.

Note to remember: If you select activities that do not fall within the update period, those activities will show no progress, when to estimate the project progress. When spotlighting activities, you can only estimate progress—percent complete, remaining duration, and so on—for activities that are within the update period. If you manually update a spotlighted activity then run Update Progress, the module will overwrite your manual changes.

Here is the detailed Video tutorial for better understanding
[paypal_donation_button align="center"]

Comments


  1. Tag: PM203A52. Let me share all of you about #5 Tips for Project Management Success,, I hope you enjoy it

    1. Plan your day using time management techniques

    As a project manager, time management skills are essential because you are dealing with a wide range of tasks that demand a quick turnaround time. Planning your day will go a long way in keeping you organized and increasing your productivity. Assist your task planning by using project management software which helps you track the work of you and your team.

    If you are not very tech savvy, a simple to-do list can also be a great organizational tool. Prioritize your most important tasks by putting them at the top of the list and less important ones at the bottom. Having a visual plan of your daily tasks helps to keep you on track and aware of time.

    Related post: Free ebook 104 secrets to become a great project manager

    2. Include stakeholders in important project conversations

    While you will have plenty of responsibilities regarding the project, don’t neglect your clients.

    Good communication is essential is keeping both parties informed of project progression, curtailing scope creep, and apprised of changing requirements. Some clients may have different expectations when it comes to communication, so make sure to establish the frequency and type of communication (like emails, phone calls, and face-to-face conversations) at the beginning of your project.

    Establishing communication expectations early helps alleviate stakeholder uncertainty about communication frequency and delivery.

    3. Regularly communicate with your team

    Daily team communication helps keep misunderstandings and unclear requirements under control. Keeping your team informed in every step of the project is essential to project management success.

    For example, a study published by Procedia Technology found that good communication skills were the cornerstone of project management. The study examined over 300 “construction project managers, architects, construction managers, engineers and quantity surveyors” and their successes and failures on various construction projects.

    4. Anticipate project setbacks

    Even the best-laid plans often go awry.

    Remember that even with a high amount of planning and attention to detail, your project may still encounter some challenges. Pay attention to complaints from stakeholders or colleagues, and other warning signs, like a missed deadline or cost overrun, that there may be a problem.

    Preventing a crisis will keep your project running smoothly, save you a lot of time, and keep you, your team, and your stakeholders confident in progressing with the project.

    Unfortunately not every complication can be avoided. Crisis management skills are essential for dealing with the unexpected. Project managers need to be flexible and pragmatic. Improvise and make sharp decisions when needed.

    Related post: 92 free project management templates

    5. Stay focused on the details

    A common problem project managers encounter is having the project aims not aligned with the organization’s objectives. A great project manager will strategize a plan for the project to lead back to the overall success of the business.

    Know your project’s scope by heart and avoid wandering outside of the project’s requirements. It’s too easy to get lost in minor details and forget what your focus is, so a well-planned project scope is essential for success.

    And final, you should use KPI to measure effectiveness of the project, here are full list: 76 project management KPIs



    ReplyDelete

Post a Comment

Popular posts from this blog

Top 4 Useful Features, Tricks You Can Use In Primavera P6 || Special features To Learn In Primavera

1. How to Increase the size of icons in Primavera P6?  If you find that the menu bar and command icons are of less visibility, there is a way to increase the size of icons in Primavera P6. Let us see how to do this in this tutorial now. Go to the menu bar and under the view tab, select Toolbars and click on customize. Now a window gets opened like this, go to options tab and tick the checkbox "Large Icons". Click on the Close button and you can see that all your icons now increased in size. 2. How to Animate your Menu Bars in Primavera P6? You know that we have got the option to animate menu bars in Primavera P6. There are 4 animation options in Primavera P6, These are None  Random  Unfold Slide  Fade  You can try any of these if you want a new feel. Follow this steps to Animate Menu Bars. Click on View, go to toolbars, select Customize. Now a customize window will pop up. Go to the options tab, at Menu Animat...

How To Merge Two Separate Schedules Into One Master Schedule In Primavera

In this tutorial, let us learn how to Merge two separate schedules into One Master schedule in Primavera P6. In this example, I am considering two separate projects which are these two, One is master schedule and one is the subproject. First, let us open the subproject and export this schedule as a .XER file onto Desktop. and now let us start the exact process of merging two separate schedules. 1. As a first step, We need to open the project schedule into which we want to insert the other project as a sub-project. So, let us open the Master schedule here. 2. Go to Import, select XER format, Click Next 3. Select Project and click Next 4. Now select the Subproject .xer file from the Desktop and click Next 5. Under Import action, select the option as “Update Existing Project” and under import to section, select the Master schedule which is already open. Click Next and Finally Click on Finish. 6. Please note and make sure that your WBS and activity IDs should not confl...

How to adjust the Legend Space in Microsoft Project

In this Tutorial, let us see how to adjust the space occupied by the Legends in Microsoft Project, enabling for a better professional print of the schedule. Step - 1: Open the Microsoft Project schedule and go to File>>Print Preview>> Step - 2: At the bottom of the print preview, you can view the Legend portion. Sometimes the legend space occupies the major portion of the page, making it unprofessional to print the schedule reports. Step - 3: So, in order to adjust this legend space,you need to go back to the schedule's Gantt chart view and place the cursor at the gantt chart and right click to select the Bar styles option. Step - 4: Here, you can view all the Legend Labels. Now start entering the symbol asterisk * at the beginning of all the labels which you intend not to reflect in the print view as shown here Now here is the Schedule layout with minimum & only required legends Step -5: Now, in addition to the ad...
